nuclear-news

The News That Matters about the Nuclear Industry Fukushima Chernobyl Mayak Three Mile Island Atomic Testing Radiation Isotope

Evacuees from Fukushima nuclear meltdown reach settlement with Tepco

Aug 26, 2026, https://www.japantimes.co.jp/news/2026/08/26/japan/crime-legal/tepco-fukushima-settlement/

SAPPORO – A total of 176 people who fled Fukushima Prefecture following the March 2011 nuclear disaster have reached a settlement with Tokyo Electric Power Company Holdings in their damages lawsuit filed against the firm and the government.

The settlement was reached on Aug. 18 at the Sapporo High Court, according to lawyers for the plaintiffs.

All the plaintiffs withdrew their damages claims against the government. The decision came on the heels of the Supreme Court’s June 2022 ruling, and a series of similar court decisions that followed, that the government was not liable for the nuclear accident.

The plaintiffs evacuated from Fukushima Prefecture to Hokkaido in the wake of the triple meltdown at the tsunami-stricken Fukushima No. 1 plant.

Under the settlement, Tepco apologized for the irreparable damage the plaintiffs suffered because of the accident.

The settlement amount was not disclosed. The plaintiffs’ lawyers said the sum was “not sufficient but took into account their claims to a certain extent.”

Seiichi Nakate, head of the plaintiffs, and his family evacuated from the city of Fukushima to Sapporo in 2012.

“The settlement is far from enough to make up for our indescribable suffering, but we decided (to accept it) because we cannot endure any more exhaustion,” he said.

In its March 2020 ruling, the Sapporo District Court ordered the government and Tepco to pay about ¥53 million in total to some of the plaintiffs, finding both liable for the accident. The plaintiffs, Tepco and the government all appealed the ruling.

September 2, 2026 Posted by | Fukushima continuing, Legal | Leave a comment

AI robots and drones to assist in Fukushima nuclear plant cleanup

Three reactors at the Fukushima Daiichi nuclear plant contain 880 tons of debris. (Photo by Akitoshi Sugiura)

Japan government, TEPCO to launch consortium as decommissioning progresses

MASATOSHI IDA, August 30, 2026

 AI robots and drones to assist in Fukushima nuclear plant cleanup. Japan
government, TEPCO to launch consortium as decommissioning progresses……..(Subscribers only)

 Nikkei Asian Review 30th Aug 2026, https://asia.nikkei.com/business/technology/artificial-intelligence/ai-robots-and-drones-to-assist-in-fukushima-nuclear-plant-cleanup

September 1, 2026 Posted by | Fukushima continuing | Leave a comment

Three years on, Fukushima’s fishers still deal with impact of treated water release

Japan Times, By Phoebe Amoroso, Aug 24, 2026

March 11 is a date of indescribable weight in Japan — one that conjures images of the devastating earthquake and resulting tsunami that killed nearly 20,000, displaced hundreds of thousands and caused catastrophic damage to the Fukushima No. 1 nuclear power plant.

But Aug. 24 has also become a date of significance for the Tohoku region and the rest of East Asia. On this day three years ago, power plant officials began releasing treated water into the Pacific Ocean — a move that, while necessary, is continuing to have an economic impact on the region’s seafood.

“There’s no single perfect method that will ensure understanding among the public (when it comes to the safety of Fukushima’s seafood),” says Tadaaki Sawada.

Sawada is deputy manager of the guidance section for the Fukushima Prefectural Federation of Fisheries Cooperative Associations (FS Gyoren). Even three years on, he laments the difficulty of eliminating the stigma attached to the northeastern coastal prefecture of Fukushima and its produce.

On the day Sawada spoke with The Japan Times, Tokyo Electric Power Company Holdings Inc. (Tepco) completed its 21st discharge of treated water currently held in storage tanks at the No. 1 nuclear plant. Three years into this process expected to take three decades in total, fears of reputational damage have not explicitly emerged within the domestic market, but other consequences have been profound: geopolitical tensions and an exposure of the vulnerabilities that underlie Japan’s fishing industry as a whole.

Difficult choices

Though the primary disasters of March 2011 are in the past, the Fukushima No. 1 nuclear power plant is far from decommissioned.

Nuclear debris remains inside the damaged reactors and still produces heat, so water has to be circulated through the damaged reactors to keep them cool and eventually discarded. A method known as Advanced Liquid Processing System (ALPS) can remove up to 62 radioactive compounds from this water to very low concentrations, but it can’t remove tritium, a radioactive isotope of hydrogen. After ALPS and dilution with seawater, the concentration of tritium in the water reaches 1/40 of the maximum threshold mandated by government regulations.

With on-site water tanks nearing capacity, Tepco — backed by the Japanese government and the International Atomic Energy Agency — announced in 2021 that it would conduct periodic, controlled ocean discharges while monitoring the resulting tritium levels.

The decision provoked strong reactions, not least within Fukushima’s fishing industry. The government had promised fishermen that it wouldn’t release the water without the understanding of local communities, and the move was perceived by many as reneging on that commitment, provoking strong fears over further reputational damage.

But three years on, a strong consumer backlash within Japan has not materialized.

Takeshi Hamada, a professor of fisheries science at Sapporo’s Hokkai-Gakuen University, has studied the economic impact on Japan’s fishing industry. He argues that one key difference between domestic reaction in 2011 compared to the years that followed is related to media coverage.

“Following the Great East Japan Earthquake, most media outlets — including major ones — viewed government information with skepticism,” Hamada says via email. “However, during the ocean release of ALPS-treated water, there was relatively little coverage questioning its safety.”

Instead, criticism mostly emanated from somewhere far away from Japan’s northeastern coast: China.

On the day the first batch of ALPS-treated water was released, Beijing banned the import of all Japanese aquatic products (the ban was partially lifted in June 2025 before being reinstated that November after Prime Minister Sanae Takaichi’s comments on Japan’s role in a hypothetical Chinese naval blockade of Taiwan).

The impact of the import ban on Japan’s fishing industry has been hard to quantify, but experts believe it has been significant. Compared to the year prior, Hamada calculates that Japanese seafood exports fell by about ¥75.8 billion (about $476 million) between September 2023 and August 2024. Analysis of the next 12 months found that exports had improved in some areas, but total seafood exports were still below the prerelease level.

For Fukushima, the exact costs cannot be isolated. Although it exported almost no seafood to China, export-bound Japanese seafood was redirected into the domestic market, weighing on prices. Based on shirasu (whitebait) prices, which were driven down by bumper catches elsewhere, Hamada estimates that average prices decreased by 8.2%.

The lack of clarity has a direct knock-on effect on compensation promised from Tepco as a condition of the water release. Fishers must demonstrate lower catch volume, catch value and sales value compared to pre-2011 to receive funds for the shortfall. Seafood processors, wholesalers and other retailers can also claim compensation by demonstrating reduced sales due to consumers or buyers avoiding their seafood products.

However, many of the costs remain hidden. In a November 2025 symposium held by the Tokyo Fisheries Promotion Foundation, Soichiro Kato, a lawyer representing affected businesses, said fishers were better placed to seek compensation because fishery federations could negotiate collectively, while many seafood processors without the same collective organizations in place had to deal with Tepco individually. He also criticized Tepco’s criteria as being too rigid and not capturing losses from reverse flow effects.

Fishing for solutions……………………………………………………………………..

Coastal landings are still subject to official radiation monitoring by Fukushima Prefecture, while FS Gyoren also conducts voluntary screening at fish markets to reassure buyers. After more than 100,000 inspections, the federation relaxed its system in April this year to cover fewer species and reduce screening from each landing or sales day to at least once a week. It hopes that this will speed up distribution and make the overall system more efficient, paving the way for expanded sales.

But each step back toward normalcy for Fukushima’s fisheries is a double-edged sword.

“When it comes to how wholesalers and distributors have reacted (to relaxed regulations), naturally, to be honest, no one directly criticizes us,” Sawada says. “But I think some people do have concerns internally. That may naturally result in transactions disappearing or decreasing. It does not appear openly, and it is difficult for us on the fisher and producer side to see.”…………………………………………………………………………….

Although Tepco has made progress toward reducing newly generated water, the discharges are set to continue for decades to come. However, FS Gyoren’s call for more support for Fukushima’s fishing industry is unchanged.

“We want to continue fishing in Fukushima Prefecture as a livelihood, not only in our generation but into our children’s and grandchildren’s generations,” says Sawada. “We want the government and Tepco to provide firm support for that.”
https://www.japantimes.co.jp/news/2026/08/24/japan/fukushima-seafood-treated-water-three-years-impact/

September 1, 2026 Posted by | business and costs, environment, Fukushima continuing | Leave a comment

Fukushima nuclear wastewater discharge marks three years amid concerns

In a statement issued on Sunday, Masanobu Sakamoto, head of the National Federation of Fisheries Cooperative Associations (JF Zengyoren), said the group’s position has not changed, stressing that it remains opposed to discharging wastewater without the understanding of fishermen and the public.

24-Aug-2026, CGTN

It has now been three years since the Japanese government began to discharge contaminated wastewater from the Fukushima Daiichi nuclear power station into the Pacific Ocean despite strong opposition and concerns at home and abroad.

Japan unilaterally launched the ocean discharge of nuclear-contaminated water from the Fukushima Daiichi plant on August 24, 2023. Since then, Japan has conducted 22 rounds of ocean discharge, releasing around 173,000 tonnes of wastewater containing tritium, a radioactive substance that purification equipment cannot remove, according to Tokyo Electric Power Company (TEPCO).

The latest round, held from July 30 to August 17, involved discharging nearly 8,000 tonnes of wastewater.

Over the past three years, TEPCO has paid a total of 96.7 billion yen (roughly $600 million) in compensation for about 1,100 claims as of August 5, including claims related to losses suffered by fishermen and businesses that have had to temporarily suspend or scale back their fishing activities due to the discharge plan.

According to The Japan News by The Yomiuri Shimbun, people in the fishing industry said most of the compensation claims were filed by those outside Fukushima Prefecture, as fishermen in Fukushima receive separate compensation for temporarily suspending their operations.

Despite the compensation, opposition to the controversial operation and worries about local fisheries’ development remain.

In a statement issued on Sunday, Masanobu Sakamoto, head of the National Federation of Fisheries Cooperative Associations (JF Zengyoren), said the group’s position has not changed, stressing that it remains opposed to discharging wastewater without the understanding of fishermen and the public.

Sakamoto noted that some countries and regions continue to impose restrictions on imports of Japanese seafood, while products such as sea cucumbers have been affected by falling prices.

“The markets that have been lost have yet to fully recover, and there are concerns over whether they can be recovered at all,” Sakamoto said, underscoring the serious challenges facing the fishing industry.

He also said government support measures were “insufficient for fishermen.”

According to The Japan News by The Yomiuri Shimbun, abalones from Iwate Prefecture had an average wholesale price of about 120,000 to 140,000 yen per 10 kilograms before the treated water discharge began. However, prices have remained low due to the suspension of exports. In 2025, the price fell as low as 60,000 yen per 10 kilograms.

To ensure food safety, fisheries cooperative associations in Fukushima Prefecture have set their own limit of 50 becquerels of radioactive cesium per kilogram for shipping marine products, stricter than the Japanese government’s standard of 100 becquerels per kilogram, according to the report.

Local fishermen remain committed to ensuring the safety of their products based on scientific standards and rebuilding consumer trust, The Japan News by The Yomiuri Shimbun reported, citing the Soma Futaba Fisheries Cooperative Association.

August 29, 2026 Posted by | Fukushima continuing, wastes | Leave a comment

Tepco begins removal of radioactive spent fuel from Fukushima No. 2 reactor


Japan Times 18th Aug 2026,
https://www.japantimes.co.jp/news/2026/08/18/japan/tepco-fuel-removal/


Tokyo Electric Power Company Holdings said Monday it has started removing spent nuclear fuel emitting high-level radiation from the pool of the No. 2 reactor at its disaster-stricken Fukushima No. 1 nuclear power plant.

Last month, the company removed 28 unused nuclear fuel assemblies, which have a relatively lower risk, from the same reactor. Tepco hopes to complete the removal of spent fuel by the end of fiscal 2028.

Tepco has already finished removing seven of the 587 spent fuel assemblies from the No. 2 reactor. Removed fuel assemblies are transferred to a safer common storage pool at the nuclear plant in Fukushima Prefecture.

The fuel removal will be suspended from October due to checks on the facility and to secure space in the common pool.

Work related to the transfer of spent fuel started in June. Spent fuel assemblies are put into a container called a cask inside the reactor pool using a remote-controlled crane. Once a cask is filled, it is lifted up from the pool and then down to a trailer outside the reactor building, and the assemblies are moved to the common pool.

Tepco has completed fuel removal from the No. 3 and No. 4 reactors at the nuclear power station, which was heavily damaged in the March 2011 powerful earthquake and tsunami.

Fuel removal is slated to start in fiscal 2027 or fiscal 2028 at the No. 1 reactor, where work to remove debris is still being carried out.

August 23, 2026 Posted by | Fukushima continuing, wastes | 1 Comment

Japan begins 22nd release of Fukushima nuclear-contaminated wastewater into ocean

  July 31, 2026, https://en.people.cn/n3/2026/0731/c90000-20483845.html

Japan on Thursday began a new round of discharge of nuclear-contaminated wastewater from the crippled Fukushima Daiichi Nuclear Power Plant into the sea, marking the 22nd such release since the controversial operation began in 2023.

According to the plant’s operator, Tokyo Electric Power Company Holdings (TEPCO), about 7,800 tonnes of wastewater containing approximately 1.3 trillion becquerels of radioactive tritium will be released into the ocean.

The latest discharge, also the fourth round of wastewater release for fiscal 2026, is scheduled to continue through Aug. 17.

In the fiscal year that began in April, TEPCO plans to release a total of about 62,400 tonnes of wastewater in eight rounds.

Struck by a 9-magnitude earthquake and the ensuing tsunami on March 11, 2011, the Fukushima nuclear plant suffered core meltdowns that released radiation, resulting in a level-7 nuclear accident, the highest on the International Nuclear and Radiological Event Scale.

Despite concerns and opposition from the international community, Japan unilaterally launched the ocean discharge of nuclear-contaminated water from the Fukushima Daiichi plant in August 2023. So far, TEPCO has completed 21 rounds of discharges, and around 165,000 tonnes of wastewater have been released into the sea.

August 4, 2026 Posted by | Fukushima continuing, wastes | Leave a comment

Fukushima nuke plant struggles to clear radioactive waste debris

By TOMOYUKI SUZUKI/ Staff Writer, July 25, 2026 https://www.asahi.com/ajw/articles/16663961

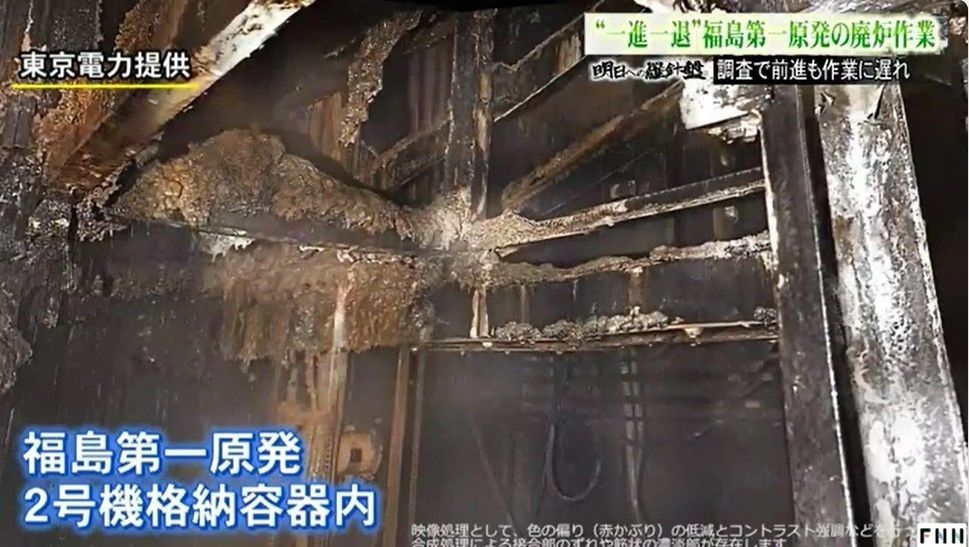

Fifteen years after the nation’s worst nuclear accident, the upper floors of the No. 1 reactor at the Fukushima No. 1 nuclear power plant remain littered with wreckage from a hydrogen explosion.

Just clearing all the radioactive waste, a significant step toward decommissioning, remains a mountain to climb at the crippled plant, which suffered triple meltdowns.

The huge amount of debris must be cleared before the plant operator, Tokyo Electric Power Co., proceeds with the removal of spent nuclear fuel assemblies stored in the water-filled cooling pool located on the upper portions of the No. 1 reactor building.

But the long-overdue clearance would require TEPCO to construct new interim storage facilities in a race against time to keep up with the increasing waste volume in what is likened to a “cat and mouse game.”

Experts on nuclear decommissioning say TEPCO and other stakeholders should tackle reducing the radioactive waste as an urgent priority in tandem with the greatest challenge of removing the melted nuclear fuel.

The No. 1 reactor building holds 392 spent fuel assemblies in the cooling pool, apart from the melted nuclear fuel.

A new crane installed on the upper floor is expected to load debris from the hydrogen explosion into containers for the transfer to an on-site solid waste storage facility. The clearing work began on June 22.

The hydrogen explosion at the No. 1 reactor building occurred on March 12, 2011, the day after the magnitude-9.0 Great East Japan Earthquake and tsunami struck Japan’s eastern Tohoku region, resulting in the loss of power at the facility to cool the reactors.

The blast blew off the structure’s upper floors, scattering numerous pieces of the roof and the overhead crane.

Today, the No. 1 reactor building is shielded with a giant retractable cover, which measures 56 meters by 66 meters. The cover, together with a new crane, weighs about 7,900 tons, the equivalent of two Tokyo Towers.

The cover was installed in January to prevent radioactive dust from escaping into the air and rainwater from seeping inside during the spent nuclear fuel recovery, which is scheduled to begin between fiscal 2027 and 2028.

TEPCO has been conducting checks of the upper floors for potential large cracks. It has been moving some debris through a remote-controlled demolition system.

Containers holding the waste from the clearance work will be stored temporarily in a solid waste storage facility at the plant.

Known as the No. 10 storage facility, it consists of A, B and C buildings. Buildings A and B have been in use since 2024. The newest one, building C, is 50 meters by 180 meters and 20 meters in height.

Inside building C, containers are neatly stacked. Receptacles with readings of high levels of radiation are sited in the center of the building and surrounded by ones with lower readings, which serve as shields to lower air dose rates in the surrounding area.

In contrast, the grounds outdoors appeared jumbled. Trees chopped down to create space for tanks and working space for operators were left lying on some parts of the grounds while waste containers were piled up in the open.

In addition, TEPCO still relies on makeshift storage in areas along the coast that stores waste on an impermeable liner spread underground and covered with soil.

The company intends to house all the radioactive waste in the indoor facilities by fiscal 2028 to safeguard the containers from fire risks and corrosion.

Before the nuclear disaster, the nuclear plant had eight waste storage facilities. The No. 9 and No. 10 facilities were added after the 2011 accident. Construction of the No. 11 facility is underway for the planned opening for May 2028.

If everything goes as planned, the nuclear plant’s capacity for waste storage would rise to 216,000 cubic meters by the end of fiscal 2028, sufficient for an estimated 207,000 cubic meters of waste to be produced by the time.

It is clear, however, that TEPCO may need additional storage space. The company is considering constructing a No. 12 facility, given that the plant’s storage capacity is projected to be full by fiscal 2035.

The entire situation is even more concerning as little progress has been made in the discussion of the final disposal of the vast amount of radioactive waste.

Moreover, waste produced from the treatment of contaminated water, such as slurry and sorbents, is not included in the materials bound for these storage facilities.

TEPCO will transport parts of such waste into the No. 1 large-scale waste storage facility during the current fiscal year. The storage area, which measures 23 meters by 186 meters and 17 meters in height, underwent seismic retrofitting recently and is ready for use.

The big question is the total amount of radioactive waste that will be generated.

The utility estimates that there will be around 800,000 cubic meters of waste by the end of fiscal 2036. But it has not provided a figure for the overall amount during the decommissioning process.

An Atomic Energy Society of Japan committee advising on the decommissioning of the Fukushima No. 1 nuclear plant estimates there will be about 5.6 million cubic meters of radioactive waste–equivalent to 4.5 Tokyo Domes–unless reduction measures are taken.

TEPCO plans to sort waste by radiation level for interim storage. Of the projected 800,000 cubic meters of waste, 70 percent is eligible to be held in solid waste storage facilities.

While the company aims to halve the volume of this waste, it is set to recycle the remaining 30 percent.

Scrap metal or concrete waste with a dose of 0.005 millisievert per hour or more will be cut or partially crushed to reduce the size. For waste with a dose of less than 0.005 millisievert per hour, TEPCO will consider having it melted for recycling.

But the facility for melting metal will likely be completed between fiscal 2032 and 2034, three years behind schedule, due to a design review.

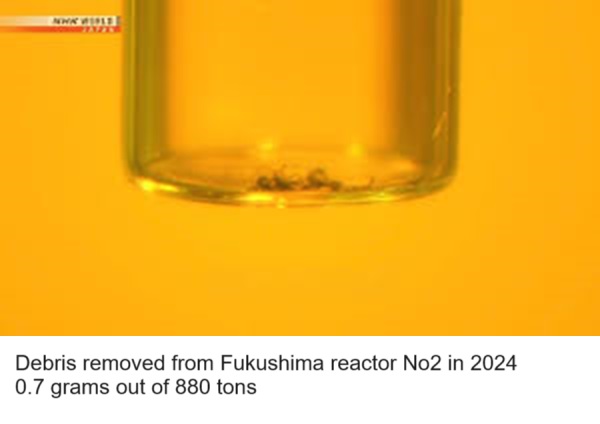

The amount of melted nuclear fuel, or fuel debris, is estimated at 880 tons at the No. 1 through No. 3 reactors where the meltdowns occurred.

TEPCO plans to eventually retrieve all the fuel debris, but it has yet to determine the final disposal method.

Satoshi Yanagihara, a guest professor for nuclear decommissioning at the University of Fukui, called on TEPCO to more aggressively reduce the waste volume.

“Since utilities’ primary focus is on operating power plants, they tend to invest less in the management of nuclear waste in terms of money and human resources,” he said. “Recovering melted fuel is certainly a daunting challenge, but TEPCO should also grapple with how to lessen the waste volume simultaneously.”

July 28, 2026 Posted by | Fukushima continuing, Reference, wastes | Leave a comment

Japan begins 21st release of Fukushima nuclear-contaminated wastewater into ocean

TOKYO, July 6 (Xinhua) Zhang Kaiwei, Liang Jun)– https://en.people.cn/n3/2026/0706/c90000-20474742.html

Japan on Monday began a new round of discharge of nuclear-contaminated wastewater from the crippled Fukushima Daiichi Nuclear Power Plant into the sea, marking the 21st such release since the controversial operation began in 2023.

The discharge started at 11:41 a.m. local time. According to the plant’s operator, Tokyo Electric Power Company Holdings (TEPCO), the latest round, scheduled to continue through July 24, will release about 7,800 tonnes of wastewater into the ocean, containing approximately 1.3 trillion becquerels of radioactive tritium.

Struck by a 9-magnitude earthquake and the ensuing tsunami on March 11, 2011, the Fukushima nuclear plant suffered core meltdowns that released radiation, resulting in a level-7 nuclear accident, the highest on the International Nuclear and Radiological Event Scale.

Despite concerns and opposition from the international community, Japan unilaterally launched the discharge of nuclear-contaminated water from the Fukushima Daiichi plant into the ocean in August 2023. So far,  TEPCO has completed 20 rounds of discharges, and around 157,000 tonnes of wastewater have been released into the sea.

July 8, 2026 Posted by | Fukushima continuing, wastes | Leave a comment

Radioactive cesium from 2011 Fukushima nuclear disaster spread over wide area: study

June 26, 2026 (Mainichi Japan), https://mainichi.jp/english/articles/20260626/p2a/00m/0na/004000c

TOKYO — A research team including members of the University of Tsukuba and National Taiwan University has clarified the dispersal routes of highly radioactive “cesium-rich microparticles” (CsMPs) released in the Fukushima nuclear disaster.

In the accident at Tokyo Electric Power Company Holdings Inc. (TEPCO)’s Fukushima Daiichi Nuclear Power Station in 2011, radioactive materials mainly contaminated areas to the plant’s northwest, but CsMPs were carried across a wide area of Fukushima Prefecture. The team also found that they were generated in large quantities four days after the March 11 Great East Japan Earthquake that year.

Actual extent of dispersal had remained unclear

CsMPs are spherical microparticles several micrometers in diameter. In the Fukushima Daiichi accident, they were formed when high-temperature nuclear fuel melted through to the floor and components of the melted concrete turned glasslike, encasing radioactive materials. The microparticles do not dissolve easily in water, and there are concerns that if inhaled they can remain lodged in the lungs, but the reality of how they spread had not been well understood.

The research team developed a method to examine the number of CsMPs contained in soil and analyzed soil samples taken from 100 locations in Fukushima Prefecture immediately after the accident. As a result, large numbers of CsMPs were found to the northwest and southwest of the plant, with as many as 52 particles per gram of soil. At some locations, 60% of the radioactivity in the soil was due to CsMPs.

The team then examined the dispersal process together with simulations of radioactive plumes, or air flows, and found that large-scale releases had begun in the early hours of March 15, 2011. A radioactive plume containing as many as 4,700 CsMPs per cubic meter was carried clockwise over a wide area of the prefecture, starting at the plant and moving from south to southwest and then northwest. It also reached Tokyo, the team said.

On the other hand, radioactive plumes released from 12 a.m. on March 16 onward contained no CsMPs. Instead, they are believed to have contained cesium in a form that easily dissolves in water.

‘Highly significant’ for future responses

Satoshi Utsunomiya, a National Taiwan University professor of environmental science on the team, said, “It is highly significant that we have clarified the process of when CsMPs were generated inside the plant and when their formation ceased.” The findings are expected to lead to decontamination efforts that better reflect actual conditions and to guidelines for responding to nuclear disasters.

Shinya Yamasaki, an associate professor of analytical chemistry at the University of Tsukuba, commented, “It has been shown that radiation maps and the distribution of CsMPs are different.”

The findings were published in the Journal of Hazardous Materials.

(Japanese original by Yurika Tarumi, Lifestyle, Science & Environment News Department)

June 30, 2026 Posted by | Japan, radiation, Fukushima continuing | Leave a comment

N-Fuel Removal from Fukushima No. 2 Reactor Pool Begins

   Tokyo, June 2 (Jiji Press), https://jen.jiji.com/jc/eng?g=eco&k=2026060200277

Tokyo Electric Power Company Holdings Inc. on Tuesday began removing nuclear fuel from the spent fuel pool of the No. 2 reactor at its tsunami-stricken Fukushima No. 1 nuclear power plant in northeastern Japan.
   The work is considered a key step in the decommissioning of the reactors at the plant in Fukushima Prefecture. TEPCO aims to complete the removal of all fuel assemblies from the No. 2 reactor by fiscal 2028.


   The No. 2 reactor’s spent fuel pool currently stores 587 spent fuel assemblies, which are highly radioactive, and 28 unused fuel assemblies, according to TEPCO. The unused fuel is being removed first because it poses a lower risk in the event of an accident.
   Radiation levels at the No. 2 reactor building are still high after the nuclear fuel in the reactor melted down in the March 2011 accident. Radiation on the fifth floor, where the fuel pool is located, measures as high as 3 to 5 millisieverts per hour, making it difficult for workers to stay there for a long time.


   Against this background, a crane for removing fuel assemblies is remotely controlled, and the assemblies are placed one by one in a transport container called a cask inside the pool. The cask will be lifted out of the pool and then lowered onto a trailer from a platform installed next to the building.

June 4, 2026 Posted by | Fukushima continuing | Leave a comment

The ongoing Fukushima nuclear disaster 15 years on: a photoessay

Peace and Health Blog. International Physicians for the Prevention of Nuclear War Tilman Ruff, April 2, 2026

It is now 15 years since the Great East Japan Earthquake on 11 March 2011—and the tsunami it generated—wrought havoc on the Fukushima Daiichi Nuclear Power Plant (FDNPP). A predictably dangerous plant design, a corrupt and negligent operator, and Japan’s incestuous and corrupted ‘nuclear village’ involving collusion and revolving doors between government, regulator and operators, combined in a lethal mix.

The myth that a nuclear disaster couldn’t happen in Japan and therefore didn’t need to be prepared for continues to exact a high toll. The Fukushima Nuclear Accident Independent Investigation Commission, the only such body ever established by the National Diet of Japan, concluded that:

“It was a profoundly man-made disaster – that could and should have been foreseen and prevented. … a multitude of errors and willful negligence that left the Fukushima plant unprepared for the events of March 11.” “… Bureaucrats … put organisational interests ahead of their paramount duty to protect public safety.”

The accident “was the result of collusion between the government, regulators and TEPCO … They effectively betrayed the nation’s right to be safe from nuclear accidents.”

“The Commission concludes that the government and regulators are not fully committed to protecting public health and safety”.

Despite this clear and damning indictment, the highest courts in Japan have acquitted Tokyo Electric Power Company’s (TEPCO) top executives and have not held the government accountable. No TEPCO executive or government official is in prison because of a huge and ongoing disaster they could and should have prevented.

The 40th commemoration of the Chernobyl nuclear disaster on 26 April this year provides another sombre milestone to reflect on humanity’s flirtation with the most hazardous technology ever invented, intimately linked with weapons that pose the most acute existential threat to the biosphere.

While both national and prefectural governments seek to present the Fukushima disaster as effectively over and the region being open for business, the resulting catastrophe is far from over. A visit to Japan in late 2025 provided a valuable opportunity to visit Fukushima for the sixth time since the disaster and learn from those grappling with the ongoing challenges to health, livelihoods and rebuilding a sustainable future in the regions affected by the disaster, which extend far beyond the boundaries of Fukushima Prefecture, even though government programs to address the disaster’s aftermath focus exclusively on Fukushima.

Because ‘luckily’ half the radioactive caesium (Cs) released by the reactor meltdowns and explosions is Cs-134, with a two year half-life, rather than the 30 year half-life of Cs-137 which makes up the remainder of the caesium released, the initial decline in residual radioactivity, to which caesium is the dominant contributor, has been faster than following the Chernobyl disaster.

The multiple damaged nuclear reactors and spent fuel pools at Fukushima Daiichi are far from stable, and decommissioning as planned by TEPCO is barely progressing and looks increasingly unfeasible. Just 0.9 grams of fuel debris has been able to be removed to date, in two removals three years later than scheduled, while 880 tons remain with no plans yet for how to remove the bulk of this material. In addition, 1,007 tons of spent fuel remain in the spent fuel pools at Units 1 and 2. The melted reactors with spent fuel pools resting above them have been severely structurally damaged. In reactor 1 for example, robotic cameras have revealed that the concrete of the pedestal which supports the reactor has melted all the way around, exposing the internal reinforcing bars now providing effectively the only structural support. These damaged structures have heightened vulnerability to further earthquake and tsunami damage.


A major independent international assessment of a kind that Japan has resisted to date is warranted to assess the best means to address this extremely challenging, highly radioactive mess to order to most effectively and expeditiously secure the site as much as possible from further fires, meltdown or criticality events, further tsunami or earthquake damage, and ongoing or escalating release of radioactive materials. While it may be feasible and challenge enough to remove the fuel remaining in the spent fuel pools above Units 1 and 2, rather than stubbornly persisting with decommissioning plans going nowhere, aiming to stabilise the damaged fuel in the reactors so that active cooling is no longer required, and establishing durable physical encasement of the damaged facilities on all sides deserve more thorough consideration.


Decontamination and redistribution

Extensive decontamination by scraping away the upper 5 cm of surface soil for 20m around houses, in fields and gardens, in schools, childcare centres, parks and public gathering places, resulting in the accumulation of 14 million m³ of contaminated soil, has denuded areas and reduced fertility of agricultural land, but has had some useful effect in reducing radiation exposure to residents and contamination of vegetables grown in decontaminated areas. Use of potassium-rich fertiliser has also contributed to reducing caesium absorption by crops. However, forested areas, which comprise 70% of Fukushima, particularly covering hills and mountains which received higher fallout than valleys and low-lying areas, act as reservoirs of radioactivity, which is constantly washed down by rain and snow to flatter and lower-lying areas where people’s homes, farms, paddies and fields lie, and also washes into estuaries and beach sands. This contributes to patchiness and high variability of contamination at a local level, and hence the importance of localised and ongoing measurement.

Hot caesium-laden particles

An important discovery was made by Japanese geochemists, particularly Satoshi Utsunomiya, that caesium-rich microparticles 2-3 microns in diameter, small enough if inhaled to be retained in the alveoli of the lung, were not only widely present in hotspots in Fukushima, but also widely deposited in Tokyo on 15 March 2011, when the most intensely radioactive fallout cloud passed over Tokyo following the explosion of the Unit 3 reactor.

These particles, assessed to be formed by the interaction of molten reactor fuel with concrete surrounding and supporting Fukushima Daiichi reactors 1 and 3, are intensely radioactive, more so than spent nuclear fuel. Contrary to conventional assumptions about the highly soluble nature of caesium and therefore (as a potassium analogue) its even dispersal in organisms and organs, these particles are insoluble, meaning they can deliver a much greater localised radiation dose to surrounding cells, and for a longer period. The main scientific publication of these findings was delayed some years because of academic infighting and political sensitivity. Their significant implications for human radiation exposures and radiation protection related to the Fukushima disaster, including the identification and isolation of radioactive hot-spots, have hardly been explored.

Public health and safety continue to be sidelined

National and regional government policies are still negligent in failing to prioritise public health and safety. In the early weeks after the disaster, the Japanese government, arbitrarily and without scientific justification, increased the maximum permissible radiation exposure for a member of the public from 1 to 20 mSv per year. This unacceptably high level is still in place, 15 years later, as the basis for government policy, including clean-up standards and the designation of areas suitable for residents to return to and ending their eligibility for government support. No other government has accepted such a continuing high radiation level for its population, including the most vulnerable, particularly children. The government is now even countenancing some return to areas where doses estimated to be received are up to 50 mSv/yr.

The Japanese government also continues other weakened protection standards, for example before the disaster, waste and soil with radioactivity more than 100 Bq/kg was regarded as strictly controlled waste, whereas since the disaster, soil which is contaminated up to 8000 Bq/kg has been classified as suitable to be treated as ordinary waste, suitable for incineration and reuse in construction works around the country.

In August 2023, Japan began discharging processed radioactive Fukushima wastewater into the Pacific Ocean. As of 22 Dec 2025, according to TEPCO, 127,000 mof contaminated water has been dumped, containing about 31.2 TBq of tritium. Such discharges are planned to continue for at least 30-40 years, in breach of Japan’s obligations under the UN Convention on the Law of the Sea, which expressly prohibits ocean dumping of radioactive waste. This will no doubt include not only the 1.4 million mof wastewater already accumulated, but contaminated wastewater which continues to accumulate for the forseeable future, at a current average of 50 m3/day, containing a raft of radioactive contaminants. Alternatives such as prolonged storage in purpose-built large tanks, or incorporating treated wastewater into concrete for underground construction use, were given no serious consideration.

An epidemic of thyroid cancer in children ……………………………………………………………………………………………………………………………………………………………………………………………………………………………………………… https://peaceandhealthblog.com/2026/04/02/the-ongoing-fukushima-nuclear-disaster-15-years-on-a-photoessay/#more-7185

May 11, 2026 Posted by | environment, Fukushima continuing | Leave a comment

Japanese earthquake and tsunami warning forces evacuation from Fukushima nuclear plants

20 Apr, 2026 By Tom Pashby

 Workers at two Fukushima nuclear power plants in Japan were forced to
evacuate to higher ground following earthquake and tsunami warnings today
(20 April). Japan’s nuclear power company Tepco (Tokyo Electric Power
Company) issued statements where they sought to reassure the public about
its plants. “At around 16.53 [local time] on April 20, 2026, an
earthquake with a magnitude of 7.5 on the Richter scale struck off the
coast of Sanriku, Japan”, it said. “As of now, there is no abnormality
with our main power system. “In response to the tsunami advisory issued
for Fukushima Prefecture, evacuation orders have been issued to workers at
the Fukushima Daiichi and Fukushima Daini Nuclear Power Stations.

 New Civil Engineer 20th April 2026,
https://www.newcivilengineer.com/latest/japanese-earthquake-and-tsunami-warning-forces-evacuation-from-fukushima-nuclear-plants-20-04-2026/

April 23, 2026 Posted by | Fukushima continuing, Japan, safety | Leave a comment

The Nightmare of Fukushima 15 Years Later

SCHEERPOST, By Joshua Frank,  March 20, 2026

“…………………………………………………………………………………… The Fukushima Daiichi nuclear plant, built by General Electric (GE) in the mid-1960s, was designed to withstand natural disasters, but its creators never foresaw an earthquake like that. When the plant’s sensors detected the quake, its reactors automatically shut down. That emergency shutdown (or scram) halted its fission process, triggering backup power to keep cold seawater flowing through the reactors and spent-fuel containers to prevent overheating. Things at Fukushima were going according to plan until that massive tsunami battered the plant, washing away transmission towers and damaging electrical systems. There were backup generators in the basement, but those, too, had been inundated by waves of seawater, and an already bad situation was about to get far worse.

A power outage at a nuclear power plant is known as a “station blackout.” As you might imagine, it’s one of the worst scenarios any nuclear facility could possibly experience. If all electricity is lost, that means water is no longer being pumped into the reactor’s scalding-hot core to cool it down. And if that core isn’t constantly being cooled, one thing is certain: disaster will ensue. The fission process itself may be complicated, but that’s basic physics. To make matters worse, there were three operating reactors at Fukushima Daiichi. Luckily, three others had already been shut down for maintenance. If power wasn’t restored in short order, that would mean that all three of Fukushima’s reactors were in very big trouble.

We would later learn that no one — not at TEPCO, GE, or among Japanese regulators — had ever considered the possibility that all the reactors might lose electricity at once. They had only drawn up plans for one reactor to go down, in which case the others could keep the plant running. But all of them offline, and every generator out of commission? There was no precedent or playbook for that.

The nuclear industry has a reasonably polite name for a disaster like the one that was rocking Fukushima. They refer to it as a “beyond design-basis accident” because no single nuclear plant design can account for every possible problem it might encounter in its lifetime. The fact that there’s a term for this should make you anxious.

Meltdowns and Fallout

Over the next several days, the emergency at Fukushima Daiichi only worsened. Every effort to restore power to its reactors hit a dead end. On-site radiation-detection equipment, which would have triggered warnings and guided evacuation efforts for those in danger, was no longer functioning. Plans to pump water into the reactors to cool them had faltered. Their cores kept overheating, and the boiling pools of spent fuel were at risk of drying out, potentially triggering a massive fire that would release extreme amounts of radiation.

Within three days, following a series of fires, hydrogen explosions, and panic among those aware of what was happening, Fukushima’s Units 1, 2, and 3 experienced full-scale core meltdowns. Over 150,000 people within an 18-mile radius had already been forced to evacuate, and radiation plumes would take two weeks to spread across the northern hemisphere, although the Japanese government wouldn’t admit publicly that any meltdown had occurred until June 2011, three months later.

The only good news for the 13 million people living 150 miles south in Tokyo was that, during and immediately after the meltdowns, prevailing winds carried much of Fukushima’s radioactive material away from the smoldering reactors and out to sea. It’s estimated that 80% of the fallout from Fukushima ended up in the ocean, meaning most of it headed east rather than toward population centers to the south and west. The other fortunate news was that the spent fuel containers had somehow survived it all. If their water levels in the pools had been drained, far more radiation would have been released.

But Tokyo wasn’t completely spared. After years of research, scientists discovered that cesium-rich microparticles had blanketed the greater Tokyo area, an unpopular discovery that drew backlash and threats of academic censorship. Areas around the Fukushima exclusion zones recorded the highest radiation levels. Japanese government officials continually downplayed the dangers of the accident and were reluctant to even classify the event as a Level 7 nuclear disaster, the highest rating on the International Nuclear Event Scale, which would have placed it on a par with the 1986 Chernobyl nuclear disaster. Japanese officials have also failed to conduct long-term epidemiological studies that would include baseline measurements of cancer rates, which has cast doubt on thyroid screenings that found troubling incidents of cancer far higher than researchers expected.

Radioactive Fish

Prior to the earthquake, the ocean’s cesium-137 levels near Fukushima were 2 Becquerels (a unit of radioactivity) per cubic meter, well below the recommended drinking water threshold of 10,000 Becquerels. Just after March 11, 2011, cesium-137 levels there spiked to fifty million before decreasing as sea currents dispersed the radioactive particles away from the coast. The ocean, however, had been poisoned.

In the years that followed the Fukushima nuclear disaster, researchers documented a frightening, yet predictable trend. Radioactive isotopes in seawater were taken up by marine plants (phytoplankton), which then moved up the food chain into tiny marine animals (zooplankton) and, eventually, to fish.

Cesium-137 consumed by fish can reside in their bodies for months, while Strontium-90 remains in their bones for years. If humans then eat such fish, they will also be exposed to those radioactive particles. The more contaminated fish they eat, the greater the radioactive buildup will be.

In 2023, over a decade after the incident, radiation levels remained sky-high in black rockfish caught off the Fukushima coast. Other bottom-dwelling species have been found to be laden with radioactivity, too, including eel and rock trout. Further concerns have been raised about the treated radioactive water that TEPCO continued to release into the ocean, prompting China to suspend seafood imports from Japan. Aside from those findings, there have been very few studies examining the effects of Fukushima’s radiation on ecosystems or on the people of Japan.

“Japan has clamped down on scientific efforts to study the nuclear catastrophe,” claims pediatrician Alex Rosen of International Physicians for the Prevention of Nuclear War. “There is hardly any literature, any publicized research, on the health effects on humans, and those that are published come from a small group of researchers at Fukushima Medical University.”

Recognizing such levels of radiation, even if confined to the waters near Fukushima, would cast the country’s nuclear industry as a significant threat — not only to Japan but globally. Any admission that Fukushima’s radiation is linked to increased cancer rates would raise broader concerns about nuclear power’s future viability. Radiation exposure is cumulative and, although Fukushima didn’t immediately cause mass casualties, it wasn’t a benign accident either. It took decades before it was accepted that Chernobyl had caused tens of thousands of excess cancer deaths. It may take even longer to completely understand Fukushima’s full effects. In the meantime, the still ongoing cleanup of the burned-out facilities may cost as much as 80 trillion yen ($500 billion).

It’s been 15 years since Fukushima’s reactors experienced those meltdowns and we still don’t fully understand their long-term repercussions. Nuclear power advocates will argue that Fukushima wasn’t a serious incident and that nuclear technology is still safe. They’ll minimize radiation threatsremain optimistic that new reactor designs will never falter, dismiss the fact that there’s simply no permanent solution for radioactive waste, and overlook the inseparable connection between nuclear power and atomic weapons. After all, among other things, we’ll undoubtedly need nuclear energy to help power the artificial intelligence craze, right?………………………………………………………………………………………………………………………………………………………………………. With nine nuclear-armed nations and roughly 12,000 nuclear warheads on this planet, worries about nuclear war are unavoidable. However, the danger of a nuclear disaster at a seemingly “peaceful” nuclear facility is often ignored. The future of atomic energy remains uncertain, but it is our duty to eliminate this hazardous energy source before another Fukushima triggers a war-like catastrophe all its own.mhttps://scheerpost.com/2026/03/20/searching-for-solace-in-a-nuclearized-world/

Joshua Frank, a TomDispatch regular, is co-editor of CounterPunch and co-host of CounterPunch Radio. He is the author of Atomic Days: The Untold Story of the Most Toxic Place in America, and the forthcoming Bad Energy: AI Hucksters, Rogue Lithium Extractors, and Wind Industrialists Who are Selling Off Our Future, both with Haymarket Books.

March 24, 2026 Posted by | Fukushima continuing, radiation, Reference | Leave a comment

Drone video from inside a Fukushima reactor shows a hole in pressure vessel, likely fuel debris

Daily Mail. By ASSOCIATED PRESS, 20 March 2026

TOKYO (AP) – A video taken by tiny drones sent into one of three damaged reactors at the Fukushima Daiichi nuclear power plant showed a gaping hole in the thick-walled steel container of the core, with lumps of likely melted fuel debris hanging from it, in a first sighting of a pressure vessel bottom since the meltdown 15 years ago.

The rare footage was taken by micro-drones – measuring 12 by 13 centimeters (4.7 by 5.1 inches) and weighing only 95 grams (3.3 ounces) each – deployed for a two-week mission to collect visual, radiation and other data from inside the Unit 3 reactor. It was released late Thursday.

The March 11, 2011 massive quake and tsunami destroyed cooling systems at the Fukushima Daiichi plant, causing meltdowns at reactors No. 1, 2 and 3.

The three reactors contain at least 880 tons of melted fuel debris with radiation levels still dangerously high. Tokyo Electric Power Company Holdings, which manages the plant, successfully took tiny melted fuel samples from the Unit 2 reactor last year, but internal details remain little known.

TEPCO plans more remote-controlled probes and sampling to analyze melted fuel and to develop robots for future fuel debris removal that experts say could take decades more.

Sending drones as close as possible to the pressure vessel’s bottom was an important goal of the latest probe, according to the plant operator, Tokyo Electric Power Company Holdings……………………………..

TEPCO spokesperson Masaki Kuwajima said officials confirmed there was a hole at the bottom of the vessel and that those hanging objects, lumps and deposits are believed to be melted fuel debris…….

The latest drone mission came nearly a decade after an earlier underwater robot probe provided a less clear picture of the inside of the Unit 3 reactor.https://www.dailymail.co.uk/wires/ap/article-15663749/Drone-video-inside-Fukushima-reactor-shows-hole-pressure-vessel-likely-fuel-debris.html

March 23, 2026 Posted by | Fukushima continuing | Leave a comment

TEPCO planning to send probe into Fukushima nuke reactor

By TOMOYUKI SUZUKI/ Staff Writer, March 4, 2026 ,
https://www.asahi.com/ajw/articles/16341286

Tokyo Electric Power Co. will soon launch a probe, the first of its kind, into the pressure vessel at one of the hobbled reactors at its Fukushima No. 1 nuclear power plant to scope out the current conditions.

The effort is part of TEPCO’s long-standing goal of retrieving melted nuclear fuel debris, left in the aftermath of the triple reactor meltdowns following the 2011 Great East Japan Earthquake and tsunami.

TEPCO officials said they are planning to insert a camera-equipped fiberscope into the plant’s No. 2 reactor to shoot footage and measure radiation levels during the first half of fiscal 2026 between April and September.

An estimated 880 tons of fuel debris remain inside the No. 1, 2 and 3 reactors at the Fukushima No. 1 plant.

TEPCO plans to approach the contaminated debris, which remains in the pressure vessels, from the tops of the reactor buildings and pulverize the debris to reduce the volume and collect it by sucking it from the side or by other means.

TEPCO officials are hoping, during the planned probe, to monitor the interior of the pressure vessel visually and ascertain the radiation levels on a location-by-location basis to help work out concrete methods for retrieving the fuel debris.

The fiberscope to be used in the probe, which resembles an endoscope, will be inserted into the pressure vessel from the side through piping.

The officials said they will be probing not the core part of the vessel but the outer side of a shroud of stainless steel, which has been installed to surround nuclear fuel, to determine, among other things, if the shroud has been deformed and if there is any debris in sight.

They said they will conduct mock-up drills in the days and months to come. They added that they will take measures to block air from leaking from the pressure vessel’s interior so workers will not be exposed to radiation.

The probe was initially scheduled to begin in fiscal 2024, but the work has been delayed because the development of a dosimeter-equipped fiberscope and other processes have turned out to be more time-consuming than expected.

“When the distribution of dose levels is known, that could, depending on the circumstances, help give an estimate of the amount of residual fuel (which has yet to turn into debris),” said Akira Ono, president of TEPCO’s Fukushima Daiichi Decontamination & Decommissioning Engineering Co., which is overseeing the corresponding processes at the Fukushima No. 1 nuclear plant.

TEPCO plans to start large-scale retrieval of the Fukushima No. 1 plant’s debris at its No. 3 reactor in fiscal 2037 or later.

The dose levels and circumstances of the areas surrounding the reactor buildings are not the same for the No. 1, 2 and 3 reactors.

TEPCO officials said they have set a target date of 2027 for studying the design of debris removal equipment and other specifics for those reactors.

2222222

March 8, 2026 Posted by | Fukushima continuing, wastes | 1 Comment
